Waycliffe ll – Wayzata

Waycliffe ll – Wayzata

Project Complete

Greetings and welcome to your project blog for the upcoming painting project at Waycliffe ll in Wayzata. We are thrilled to be back onsite this summer.

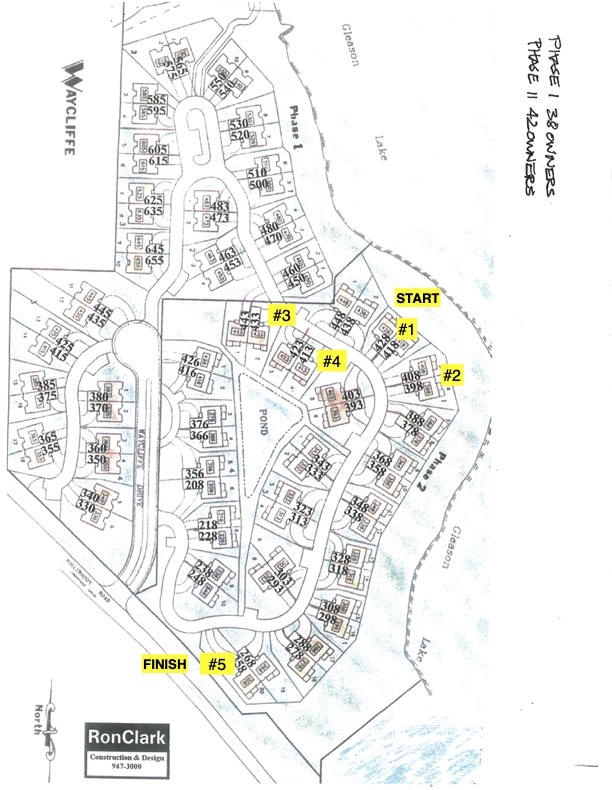

Buildings Pressure Washing Start Date  Prep/Painting Start Date
Building 1 – 428 / 418 Tuesday, 5/31 Thursday, 6/2
Building 2 – 408 / 398 Friday, 6/3 Tuesday, 6/7
Building 3 – 443 / 433 Friday, 6/3 Wednesday, 6/8
Building 4 – 423 / 413 Friday, 6/10 Tuesday, 6/14
Building 5 – 268 / 258 Friday, 6/10 Thursday, 6/16

Friday, July 8th: Greetings Residents of Waycliffe ll!

The crew has performed all needed touch ups and your project is officially completed! It has been our pleasure being onsite again this summer and being able to work with & for you. Thank you again for having us!

Wednesday, July 6th: Good morning!

The crew has essentially wrapped things up with your project. Your project supervisor, Jesse, has been onsite to mark areas in need of touch up with blue tape. The crew is now working on completing those touch ups and your project will officially be completed by the end of the day. It has been our pleasure being onsite and working with you this summer!

Wednesday, June 29th: Greetings!

Monday, June 27th: Good afternoon!

The crew is onsite and continuing to work diligently on your project. Today they are working on prepping and painting at Building 2.

The windows are covered and ready for the painting to begin.

Wednesday, June 22nd: Greetings!

Monday, June 20th: Good morning!

Today the crew is working on prepping and priming at Building 3 in preparation to begin the painting process. Stay cool today!

Building 3 is prepped and primed!

More prep and priming work completed on Building 3.

Friday, June 17th: Greetings!

The rain is finally gone and the crew is onsite. Today they are working on prepping and painting Building 5. Have a great weekend!

The garage doors are prepped and ready to go.

Rolling on the paint to ensure the best final result.

Wednesday, June 15th: Good morning!

The crew will be returning tomorrow to begin the prep and painting work on Building 5. Thank you for your patience with our schedule changes due to the weather this week.

Monday, June 13th: Greetings!

The crew will not be onsite today due to the rain. They will return when the substrates have had time to dry.

Friday, June 10th: Good morning!

The crew is continuing to work on Building 3 today. They have wrapped up the prep work on this building and have moved on to begin the painting.

Building 3 is looking great!

Working hard on this beautiful Friday.

Wednesday, June 8th: Good afternoon!

The crew is continuing to work diligently on your project. Today they are beginning the prep work on Building 3.

Building 3 before the prep work begins.

Tuesday, June 7th:  Despite some measly little sprinkles this morning, the threat of rain has subsided and the crew continues work on Building #1. Thank you to the residents of Buildings #2-#5 for clearing the way for pressure washing today! A few homeowners are contemplating a color change so once we finalize a color palette for those particular units, work will continue as planned.  The weather appears to be cooperative the remainder of the week so hopefully that bodes well for continued progress!

The respective brain trusts at Roell Painting and Waycliffe 2 huddled up this morning to discuss color strategy!

Thursday, June 2nd: Good morning!

Our crews will begin pressure washing Building 2 and Building 3 tomorrow, June 3rd. Just a reminder that if you are in one of these buildings to please close your windows & remove any small personal items from the outside of your home. Once the washing is complete, you may return your personal items to the outside of your home.

Once the substrates have had time to dry, the crew will return to begin prepping and finishing the included surfaces. Weather permitting, we are projecting the painting work to begin on Building 2 as early as Tuesday, June 7th.

Wednesday, June 1st: Greetings!

Tuesday, May 31st: Good afternoon!

We hope everyone had a wonderful Memorial Day Weekend. The crew is onsite and your project is officially underway! They kicked things off today with pressure washing. The crew will return on Friday, June 3rd to begin painting at the first building, weather permitting.

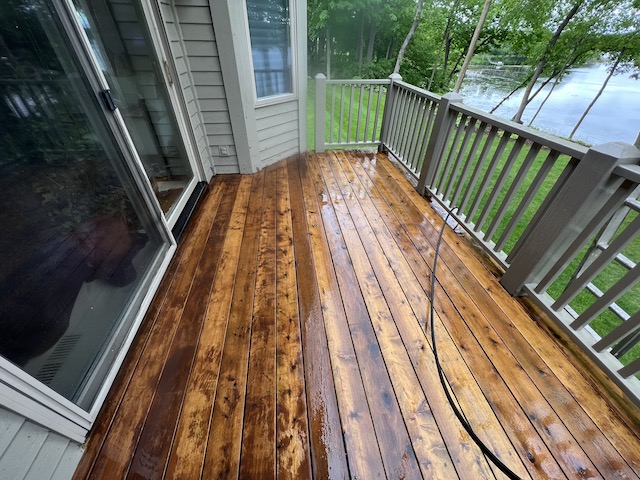

Pressure washing the deck!

Friday, May 27th: Greetings Residents of Waycliffe ll!

Welcome to your project blog for the upcoming painting project. We are looking forward to sprucing up your exteriors.

Our crews are scheduled to begin pressure washing your building and deck on Tuesday, May 31st. We kindly request that homeowners close their windows & remove any small personal items from the outside of your home for the pressure washing to allow for safe & unobstructed access for washing. Once washing is complete, you may return your personal items to the outside of your home.

Once the substrates have had time to dry, the crew will return to begin prepping and finishing the included surfaces. We are projecting the painting work to begin at the first building on Friday, June 3rd.

This project will take about 4-6 days to complete each home. In order to access the most current updates, check back here frequently to view any posted weather delays or other scheduling updates.

Please reach out to the contacts below if you have any questions.

We are looking forward to getting started next week!


Eric Derus

Project Manager
Ph: 763-559-5296
Email

2021
Houzz Best Of 2021 - Client Satisfaction

Houzz Best Of 2021 - Client Satisfaction

This professional was rated at the highest level for client satisfaction by the Houzz community.
2020
Best of Houzz 2020 - Client Satisfaction

Best of Houzz 2020 - Client Satisfaction

This professional was rated at the highest level for client satisfaction by the Houzz community.
2019
Best of Houzz 2019 - Client Satisfaction

Best of Houzz 2019 - Client Satisfaction

This professional was rated at the highest level for client satisfaction by the Houzz community.
2018
Best of Houzz 2018 - Client Satisfaction

Best of Houzz 2018 - Client Satisfaction

This professional was rated at the highest level for client satisfaction by the Houzz community.
2017
Best of Houzz 2017 - Client Satisfaction

Best of Houzz 2017 - Client Satisfaction

This professional was rated at the highest level for client satisfaction by the Houzz community.
2016
Best of Houzz 2016 - Client Satisfaction

Best of Houzz 2016 - Client Satisfaction

This professional was rated at the highest level for client satisfaction by the Houzz community.
2015
Best of Houzz 2015 - Client Satisfaction

Best of Houzz 2015 - Client Satisfaction

This professional was rated at the highest level for client satisfaction by the Houzz community.

Tags:


Leave a comment

Questions? Ask the Blue Tape Guy

roell logo

Office: 763-559-5296
Fax: 763-557-9597
7301 Penn Avenue South
Minneapolis, MN 55423
